Business continuity plan

Version History

Annual Review Conducted OnVersion ReviewedIs Change Required (Y/N)Remarks
Version 1.029-05-2020NOk
Version 1.018-04-2021NOk
Version 2.002-02-2022NOk
Version 2.003-04-2023NOk
Version 2.126-05-2023YOk
Version 3.012-01-2024YOk



Amendment History

VersionDateAuthor (function)Reviewed byApproved byNature of changes
Version 1.023-05-2020Parveen KumarDevOps FunctionGaurav SharmaFirst Integrated Issue
Version 1.018-04-2021Parveen KumarDevOps FunctionPankaj KankarNo Change
Version 2.002-02-2022Parveen KumarInfoSec functionArun KumarEntity name and Logo Change
Version 2.003-04-2023

Manhar

Sharma

InfoSec

function

Ratnesh RanjanNo Change
Version 2.126-05-2023

Manhar

Sharma

InfoSec

function

Ratnesh RanjanSoft Drill update
Version 3.012-01-2024

Manhar

Sharma

InfoSec

function

Ratnesh RanjanSoft Drill & Drill cycle update
Version 4.006-03-2024Seraj Ahamad Ansari

InfoSec

function

Ratnesh RanjanTemplate updated for enhanced clarity and summary.




Introduction

The purpose of developing a Business Continuity Plan for FarEye Technologies Pvt. Ltd. (Hereinafter- FarEye) is to ensure the continuation of the business during and following any critical incident that results in disruption to the normal operational capacity.

In the event of a disaster which may disrupt the services of FarEye SaaS services, this document is to be used by the responsible individuals to coordinate the FarEye’s system recovery. The plan is designed to contain, or provide reference to, all the information that might be needed at the time of the recovery. This plan is designed to ensure Business Continuity of FarEye SaaS service offering.

Note

This plan is not intended to cover Business Continuity for the operations team of FarEye.



Business Continuity Management At FarEye

FarEye is committed to its critical business processes and that of its valued customers. The resilience of FarEye to ensure high availability of its services to customers during contemplated business disruptions and thereafter until resumption of Business as Usual. In order to comprehend the viability and readiness of its Business Continuity Management, the exercising of BCP/DR drills through auditable plan, execution, inference and incorporation of lessons learnt are institutionalized. To augment the customized BCP for its adequacy and effectiveness, the framework is aligned to meet the ISO 22301:2012 standards (earlier BS25999).

The objective of this BCP, developed in line with FarEye’s corporate-level BCMS policy, is to prevent & contain potential disruption of services to its operations having an impact on its customers and to associates. It lays down the communication, escalation and actions necessary in the event of an incident or business disruptive situation. It will provide FarEye with a well-researched approach and process to resume services at acceptable service levels within acceptable periods with a view of minimizing the business losses and providing cost-effective measures while providing alternate services.

Business Continuity Planning At FarEye

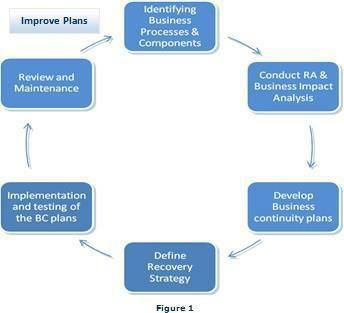

BCP Infographic – FarEye Security




Business Continuity Strategy

This section of the FarEye business continuity plan describes the strategy devised to maintain business continuity in the event of any kind of technical disruption into the FarEye SaaS services. FarEye offerings are technology driven therefore always ensured to automatically recover from a disaster.

Preventive Measures

This subsection covers all the measures taken to ensure the High-Availability of FarEye SaaSservices.

Data Center/ Cloud Infrastructure

FarEye application is hosted on AWS/ Azure cloud which operates in multi-availability zones.

Application Load Balancer

The Application load balancer works as a single point of contact for the clients. It distributes incoming application traffic across multiple application nodes. The application load balancer is configured in high-availability mode to ensure uninterrupted services.

Application

The application nodes are configured in clustering mode to ensure high-availability and to minimize the dependency on one application node. Enough buffer resources have been maintained in all application modes, so it doesn’t get stuck at peak time.

Database

The database is also configured in clustering mode to ensure high - availability. Enough resources have been kept in buffer, so it keeps functioning even in peak time with high load.

Recovery Priority

The strategy is to recover critical services of FarEye on high priority. This can be possible if a recovery strategy has been put into effect by DevOps/Technology teams to provide the recovery services. A list of key services and key customers should be available with the respective Technology Operation team.

The services which are more critical for FarEye and may impact the majority of client and FarEye services,should be prioritized for recovery.

Scope - Critical Process

This document covers all the following areas:

  • FarEye Application System
  • Database System
  • Network Infrastructure
  • Server Infrastructure
  • Data storage and backup system
  • Mobile application
  • Integration Platform
  • Cloud Infrastructure

Note

This document does not cover FarEye operations team and internal function. Please refer to the process specific BCP plan for the same.



BCP/DR Drill

To test the effectiveness of Business Continuity Plan & scenarios defined in the plan, FarEye has BCP/DR Drill plan in place.

Drill Cycle

There is a half yearly drill cycle that is defined to be carried out. These drills are conducted against the scenarios defined in this document and to check the readiness of BCP/DR plan.

Soft BCP/DR Drill

Soft drills are conducted on a half yearly basis for FarEye application where the last backup of Database & File systems are being restored and tested.

BCP/ DR reports

Drill reports can be shared with the customer upon customer request.

Recovery Procedure Of Critical Processes

The scope includes complete failure scenarios and other failure scenarios in the different business functions for FarEye Application

Complete Application Crash

Though this is the most unlikely scenario for FarEye as we are running our database in cluster mode from multi availability zones. Still, FarEye has requisite Business Continuity Planning and Disaster Recovery Process in place to ensure uninterrupted Services to clients and shall also provide all reasonable assistance to the Clients in its Business Continuity Planning procedures.

In case of a complete database crash. Maximum of 4 (Four) hours (RTO) with recovery point of 24 hours (RPO) — recovered from last transactional log backup, from one or more locations due to any unforeseen event. The TATs and service levels will be suspended during this time.

Declaration of this Scenario will be done by the Emergency Management Team

Other Scenarios

This section lists out the other failure scenarios of application and database services.

First response by Email: support@fareye.com - App support Helpdesk function replies to the emails received from the employees of the client. Query is logged under Fresh Desk, every user on a first come first serve basis. The same query appears in the new list of every associate. Any response received from the SPOCs will be redrafted and forwarded to the employee as resolution. Query is closed in the case management tool (Freshdesk tool) if the complete resolution has been provided to the employee.

Scenario 1: Issue in FarEye application (any specific module is not accessible)Recovery Procedure

Restoring a day-old FarEye application configuration from backup server. BCP Activation Time 15 min

Recovery Time Objective (RTO): 4 Hours

Recovery Point Objective (RPO): 24 Hours

Recovery Location Office:

FarEye, 5th Floor

Lotus Business Park, Plot 6, Noida, 201304

Datacenter: AWS/ Azure Recovery Steps — Summary

Client to be notified immediately by respective SPOCs.

Responsibility

Respective Technology Leads, IT, DevOps, Application Support.



Scenario 2: Issue in Application Database

This scenario takes care of the business outage due to database (may be partial or complete damage) Partial Damage.

All the scenarios covered the partial damage (due to database corruption, deletion, etc.) that impact database comes under this category.

RTO for Partial Damage: 4 Hrs

RPO for partial Damage: 24 Hrs.



Complete Damage

All scenarios covered in “Complete Failure Scenarios” and damage that impact the database come under this category.

RTO for Complete Damage: 4 Hrs.

RPO for Complete Damage: 24 Hrs.

Recovery Location Office:

FarEye, 5th Floor

Lotus Business Park, Plot 6, Noida, 201304

Datacenter: AWS/Azure

Responsibility

Respective Team Leaders, IT, Cloud-Ops, DBA, Application Support.

Notification

Sr.LayerActivityResponsibleAccountableConsultInform





1

EM (Event Management)Call logging with Support Desk or Freshdesk tool (support@fareye.com)Support TeamSupport Team ManagerStandard operating procedures and Vendor support directory

DevOps - SME, CISO TEAM,

Other Impacted Function





2

CCPNotify vendor and internal SME’sSupport TeamSupport Team ManagerProcess SMEDevOps - SME, CISO TEAM, Other Impacted Function





3




CCP

Notify vendor to initiate supplier continuity plan to provide support and monitor





4

CoBTechnology Impact analysis for Support function and Service delivery UnitProcess Team, Information Security TeamProcess Lead DevOps lead- Service notification to all stakeholders





5

CoBActivate plan – Tech Infra, DevOps, Service Delivery Unit, and supply chain providersProcess Head, CISODevOps Manager, Process Manager

DevOps- SME, CISO TEAM,

Business Head




6

EMEvent communicationSupport TeamProcess Lead DevOps- SME, CISO TEAM, Business head





7

CoBBusiness or Support unit business impact assessment and continuity/DR action plan activationService Delivery Unit,Information Security TeamFunction HeadSupport TeamService Delivery Head, Stakeholders










8

EMContinuity event management ROTA for First Assessment of impacted business units for appropriate and adequate strategy activation requirements in lieu of the IT operations disruption notified by Service Desk

Service Delivery Unit BCL,

DevOps lead, CISOTEAM

Service Delivery Head, DevOps Head, CISO TEAM

SLA with vendors. RTO and SLA per business needs RTO

aligned to business needs and customer alignment

Service Delivery Head, Function head, Customer communicate on, Associates engaged in the event, stakeholders





9

PSEnsure SMEs are provided with transport and guest house facilities for extended outage periodsProcess Manager/Admin managerEmail CommunicationProcess Head, Function head, Admin manager,





10

APIT infrastructure, damage assessment and Insurance ClaimsLocation Finance / Admin managerLocation Finance / Admin managerProcess Lead, Admin, FinanceManagement





11

ESHVAC at Premises available for operations recoveryLocationADMIN managerLocationADMIN headSupply Chain LocationPRACCouncil, Business leaders, LC, MSACF










15

CoBMonitor the SLA agreed Vs SLA delivered for RTO alignment and change recommendations in post event action plan. List of vendors, services, SLA agreed Vs SLA deliveredDevOps, Service Delivery Unit Head, Information Security teamCISO TEAMBCL TeamCISO and Service Delivery Head







16

CoBAssess BIA, announce plan up to Week 2 and monitor to report every week meetingBCL, Function heads and Support teamsFunction headsFunction head and CISO TEAMCouncil, Admin, DevOps, CISO TEAM, Leadership council





17

CoBRecovery and Restoration of operationsService Delivery Unit, Dev OpsService Delivery Unit,Dev OpsBC Plans, customer priority if any, RTO and/or SLALeadership teams





18

CoBAnnounce Return of business to normalFunction headManagement security and continuity forum chairServices Delivery Unit headMSACF Location Council
19ATRAfter event meeting and action to owner trackingCISO TEAMFunction headSupport and Business teamsManagement




20

ATRTrack actions to closureCISO TEAMFunction headSupport and Business teamsManagement




21

ATRReport risk exposures to Management Security ForumCISO TEAM

Function

head

Support and Service Delivery UnitManagement





22

ATRActions track management security forum continuity improvement planCISO TEAMFunction headSupport and Service Delivery TeamManagement



Incident Reporting

The PM/BCL shall ensure that the ADMIN manager / CMT Leader/ERT of the location and or IS team are informed of disruptions of the incident at the earliest. Further, periodic communication will happen to keep all stakeholders posted on the progress.

The PM/BCL shall document and share the Incident report to relevant stakeholders, including the IS team. The incident management process will be followed to ensure prompt alerts and incident handling. Incident escalations will follow the Communication plan mentioned in the BCP.

Incident Report for Emergency Template is available at BMS /Web Qualify.

Incident Response Command Structure And Control Flow

The response ownership during disruption needs effective command structure for execution of planned activities, spot decisions and contingency strategies. Within the scope of the business requirements of the project/ Business Unit, the authority and segregation of accountability is tabulated below to ensure effective governance and planned execution.



Sr.ActivityOwner
1Reporting of the incidentFirst respondent
2Record as an incidentSupport Team
3Assessment call to classify the incident in scope of cyber securitySME: DevOps, Service Delivery unit, CISO TEAM,
4Severity assessment – Cyber security – IT infrastructure, DevOps to assessment of Applications/Database infrastructureDevOps, Service Delivery
5Severity assessment review – Infrastructure, Data, Apps,CISO TEAM
6Assessment Call (CISO TEAM is the lead assessor of the cyber event call)

CISO TEAM,

DevOps stakeholders

7Assessment call agenda discussion Environment impact Cyber Infra, DevOps, Apps, Database, Business impact analysis Business operations impact – immediate impacts and RTO brief as per documented BC plans Decision to activate business continuity plans for selective or all




Admin, DevOps, CISO Team

8Notification to stakeholders.CISO TEAM/DevOps
9

Business units/ Delivery team/ Function Unit to communicate to partners, customers, teams around

impact and readiness with continuity plans and actions summary

Project Lead, Function Head
10Monitoring Cyber Event management to closure – End to EndCISO TEAM
11IMS records and governanceCISO TEAM



Communication To Client And Stakeholder

The Communication team will be responsible for informing clients about the disaster and the impact. The best and/or most practical means of contacting all the clients will be used with preference on the following methods (in order):

  • E-mail (via corporate email where that system still functions).
  • E-mail (via non-corporate or personal email).
  • Telephone to employee home phone number.
  • Telephone to employee mobile phone number.

The clients will need to be informed of the following:

  • Anticipated impact on service offerings.
  • Anticipated impact on delivery schedules.
  • Anticipated impact on security of client information.
  • Anticipated timeline.

Communicating to Partners

After all the clients have been informed about the disaster, the Communication team will be responsible for informing partners of the disaster and the impact.

Crucial partner will be made aware of the disaster situation first. Crucial partners will be e- mailed first then called to ensure that the message has been delivered. Required support should be taken from the partner at time of disaster to restore to the normal operation. All other partners will be contacted only after all crucial partners have been contacted.



Communicating to another Stakeholder

The Communication team will be responsible for informing the remaining stakeholders of the disaster and the impact.

Post Disaster Activities

Once the disaster has been controlled and business resumes back to normal state, following tasks should be carried out as part of Post Disaster Activities:

  • Return to normalcy after restoration services
  • Lessons Learnt/Key learning’s would be Update in BCP – if required.
  • The PM/BCL shall create an incident report stating details of Disaster and impact realized.
  • Identify impacted business functionality and recovery mechanisms if any.
  • Identify impact on SLA adherence if any.
  • Carry out root cause analysis for the disaster and action item for the team if any.

Mandatory Documents Needed

Sr.Document
1.RA & RTP of the Project/ Business Unit
2.Project specific Installation & configuration procedures
3.Project management data repository / details
4.BIA assessment.
5.Write-up / SOP on each of the Critical Processes declared
6.BCP/DR drill evidences
8.Incident Response Procedures for identified threats
9.Incident Report document
10.Critical Resource Contact list




Acronyms And Their Expanded Form

Sr.AcronymExpanded Form
1.BCMBusiness Continuity Management
2.BIABusiness Impact Analysis
3.BCPBusiness Continuity Plan
4.DRDisaster Recovery
5RTORecovery Time Objective
6.MAOMaximum Acceptable Outage
7.MBCOMinimum Business Continuity Objective
8.RA/RTPRisk Assessment/ Risk Treatment Plan
